Microsoft Project 2016 Tutorial for Newbies

By Kate Eby | November 4, 2016 (updated August 29, 2022)

A project plan is an essential part of any project manager’s toolkit. While it can be tempting to get started on completing tasks as soon as possible, taking the time to map out your strategy can help you save money and resources. Your project will constantly be shifting, and you need a project plan template that can keep up.

Microsoft Project (MS Project) has been around a long time (the first edition launched in 1984) and it is a staple in a project manager’s arsenal. There’s good reason - it includes all the tools you need to assign resources, track progress, develop plans, manage budgets, and create schedules. Effective project management requires tools like MS Project that are both flexible and provide structure. However, Microsoft Project has a couple of limitations. First, it only works on PCs, and second, MS Project requires a license to use. If your company already uses Microsoft Project, those issues may not be challenges for you.

To help you get started with Microsoft Project 2016, this tutorial will walk you through the steps to create a project timeline, assign resources, and run reports. If you want to create your own project, you’ll need an MS Project license (which is likely supplied by your company). We’ll also demonstrate how to perform the same tasks in Smartsheet for a MS Project alternative. Since Smartsheet is a cloud-based web app, you can use a PC, Mac, or mobile device and share your work with anyone.

How Would You Like to Create a Project?

Smartsheet

How to Use Microsoft Project

Microsoft Project is a powerful tool for the creation of charts, timelines, task sheets, and more. Use it to help your team keep track of project progress, create schedules, and visualize data.

For this tutorial, we’ll be using Microsoft Project 2016. There are many versions available, but many of the steps will translate well among them. This MS Project tutorial will cover the basic features that are found in most versions.

Features of Microsoft Project

Microsoft Project includes features to set up projects and run automated reports based on progress, budget, and time tracking. With it, you can set up timelines, add and schedule tasks, set up dependencies, add resources, and track progress.

See a head-to-head comparison of Smartsheet and Microsoft Project

Discover how these two tools compare across six key factors, including: user experience, shareability, reporting, automation, integrations, and price.

Watch the full comparison video

How to Create a Timeline in Microsoft Project Tutorial

To create a timeline in Microsoft Project, create a list of tasks with start and end dates for each. Then, add those tasks to the timeline. We’ll guide you through the process step by step below:

1. Create a Task List
You’ll need to build a list of required tasks. While building the list, try to prioritize them in the order they need to be completed. To get started, open Microsoft Project, click Blank Project, and type each task into a cell under Task Name.

2. Add Start and Finish Dates to Each Task

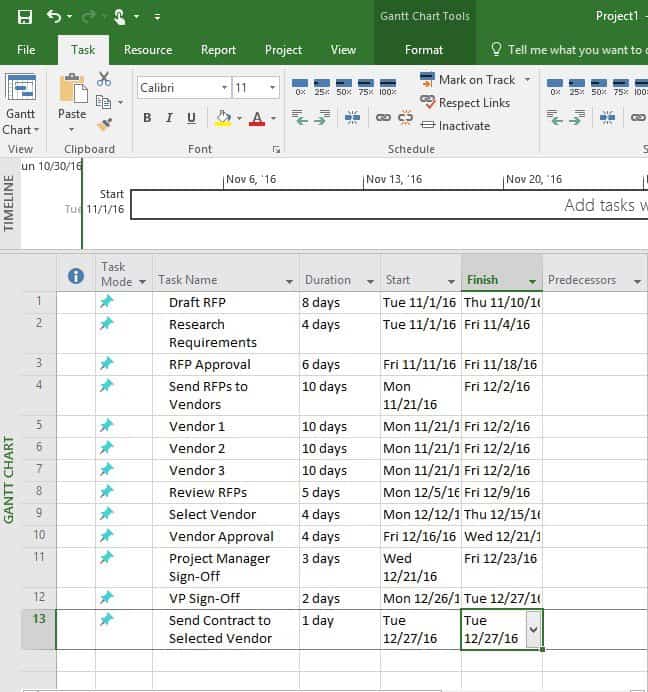

To enter start and end dates, click the Start cell that corresponds to the first task and enter a date (if you click the down arrow in the cell, a calendar will appear and you can use that to select a date). Then tab over to the Finish row and enter an end date. Microsoft will automatically enter the amount of time it will take to complete the task in the Duration row. You’ll notice that as you add the dates, bar charts will be added to the timeline in the right-hand pane.

3. Add Tasks to the Timeline

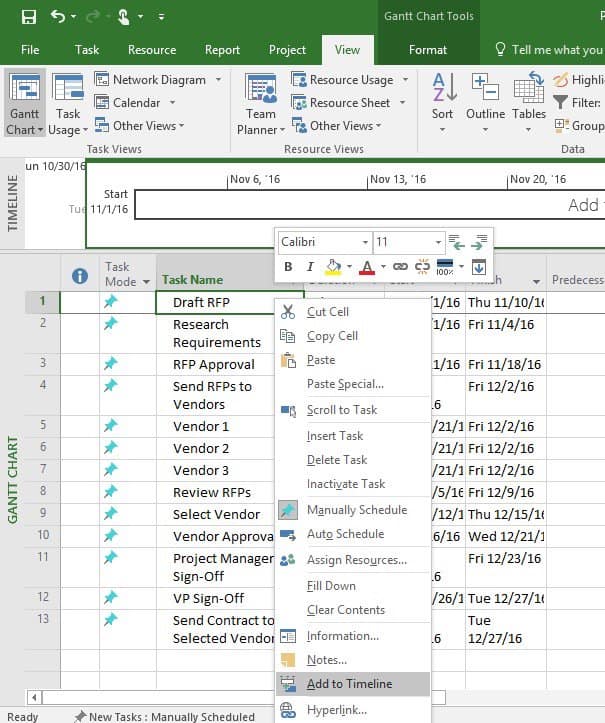

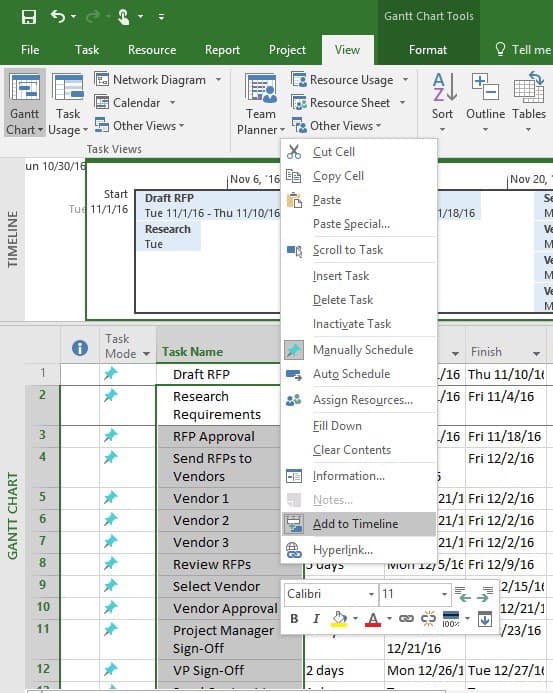

To add tasks to the Timeline, click the View tab and click the Timeline bar that appears above the task list. Then right-click on a Task cell and choose Add to Timeline from the list and click it to add the task to the timeline.

Tip: You can select all tasks in the list and then right-click on the mouse and select Add to Timeline to add all the tasks simultaneously.

How to Set Up Resources in Microsoft Project

Set up resources in Microsoft Project through the Resource tab in your project. Use this tab to establish the people, or resources, that will be assigned to tasks on your timeline. We’ll guide you through the steps below:

1. Open the Resource Sheet
From the View tab, click Resource Sheet. The Resource Sheet will appear on the screen.

2. Add Resources

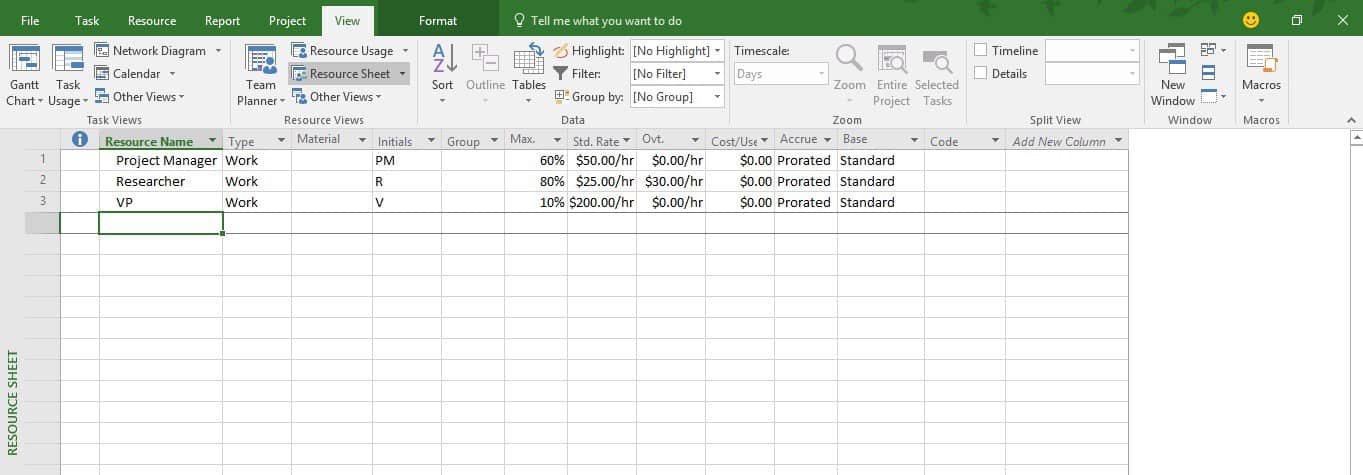

Type the name of the resource needed in the Resource Name field and complete the remainder of the information: Type, Material (if it’s a material), Initials, Max (max amount of time), Standard Rate, Overtime, Cost/Use, Accrue, Base, and Code.

Once your resources are added to the project, you can easily view who is available to take on the task based on their workload, and manage how much time each team member will spend on tasks in the Resource Management view. (Smartsheet is an ideal tool for project managers because the Resource Management feature provides real-time information about your team’s availability in one sheet, so you can easily make decisions on assignments and update responsibilities to maximize your team’s time.)

How to Assign Tasks in Microsoft Project

Once you have created a timeline and set up your resources in Microsoft Project, use the Gantt chart view to assign tasks. We’ll walk you through using the task form to assign tasks to your resources below.

One benefit of MS Project is that it can calculate the time it will take a person to complete a task based on their availability. If an important part of the project needs to be done quickly, you can assign multiple people and the program will estimate the time needed to complete the task accordingly. This also alerts the people assigned to the project to the time that is required of them.

1. Switch to the Gantt chart
To assign tasks, you’ll need to switch to the Gantt chart. Click the Gantt chart icon in top left corner of the window.

2. Open the Task Form
You should still be in the View tab. Click the Details box in the ribbon. The Task Form should appear on the lower half of the screen. If it doesn’t appear, click the down arrow in the Details box and select Task Form.

3. Select a Task to Assign

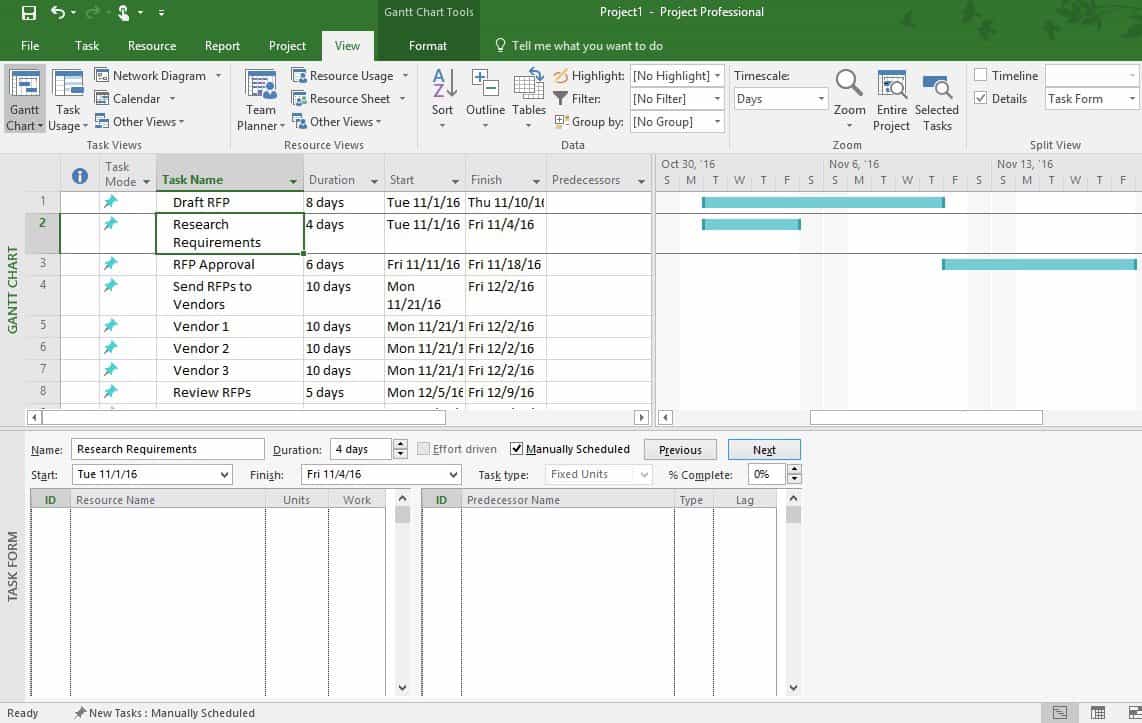

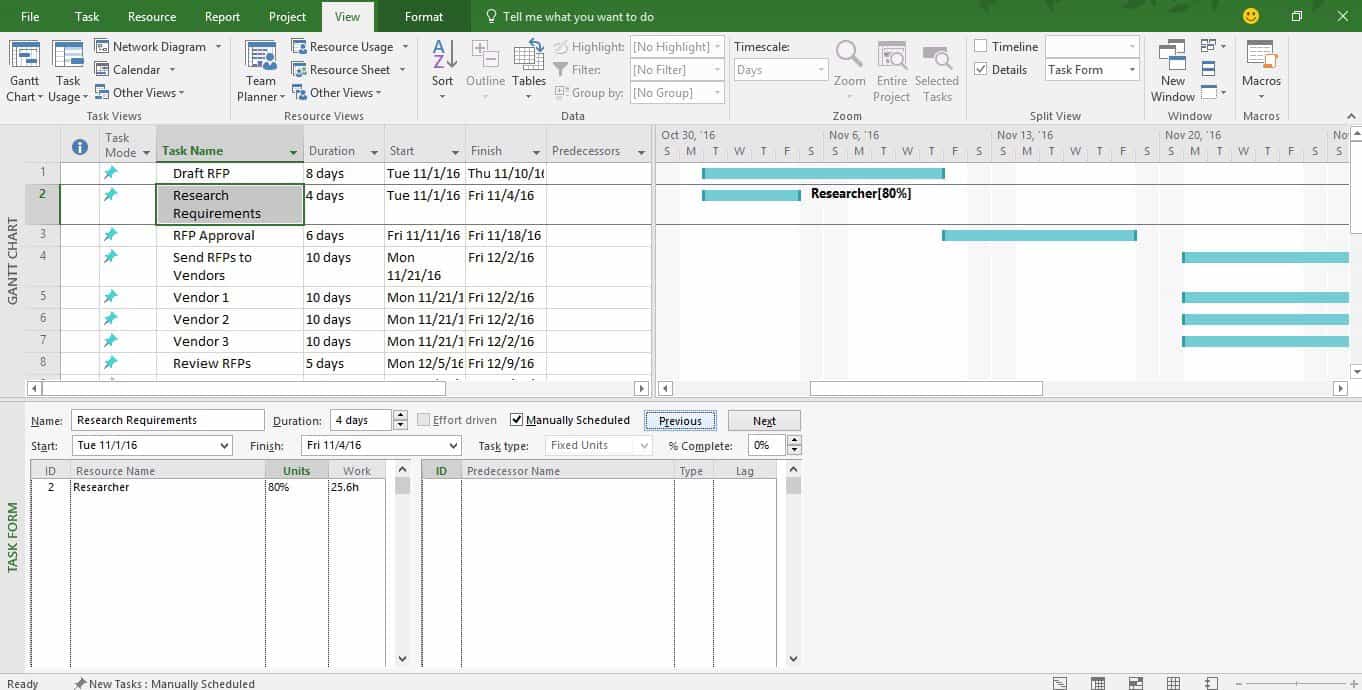

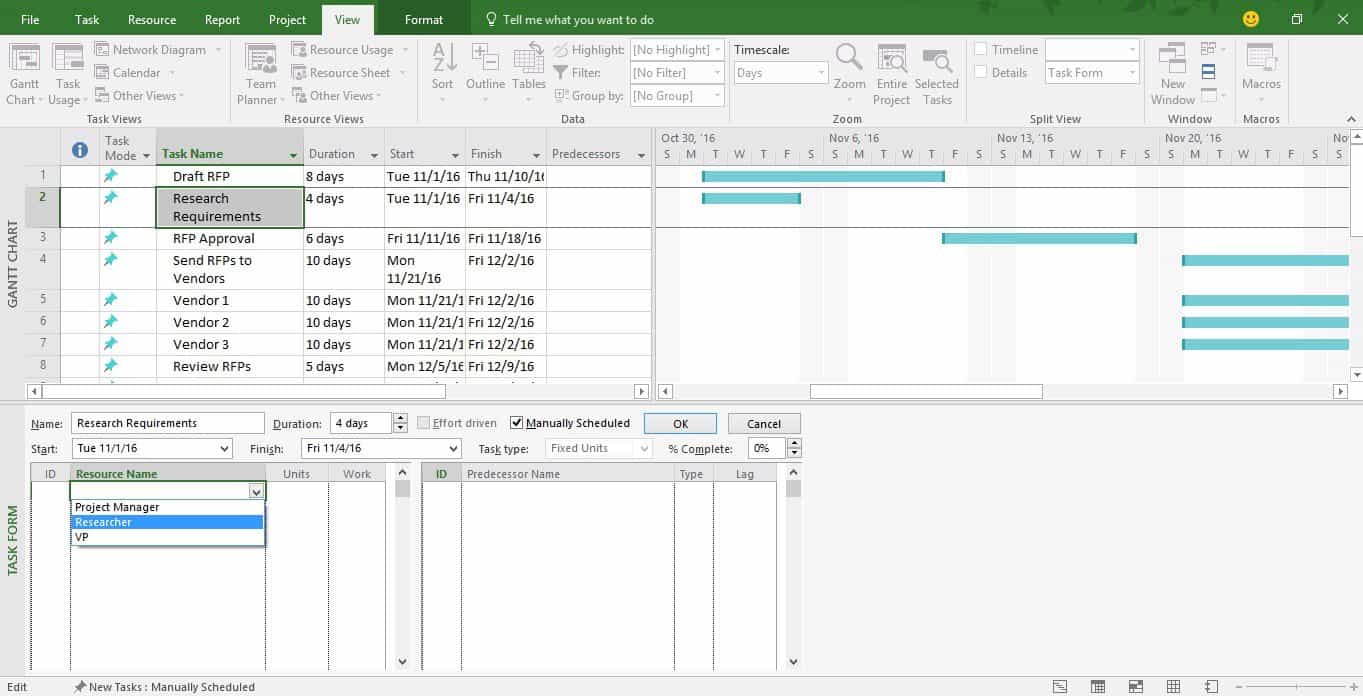

Click a task in the Gantt chart view and it will appear in the Name section of the Task Form. Click the box under Resource Name and choose a resource from the drop-down menu. Then click OK.

You can add another person to the same task by clicking the area under Resource Name and choosing the name you want. Click OK. As you assign tasks, the amount of time will be added to the Gantt chart.

Repeat steps to assign all the tasks.

Note: Clicking the Next button (located on the right side of the OK button) will load the next task in the Gantt chart.

How to Schedule Tasks Automatically in Microsoft Project

When scheduling tasks with Microsoft Project, you have two options. You can assign and track tasks manually, or use the automatic feature to schedule tasks based on dependencies, calendars, and constraints. Learn how to use the automatic feature below:

1. Access Microsoft Project Settings

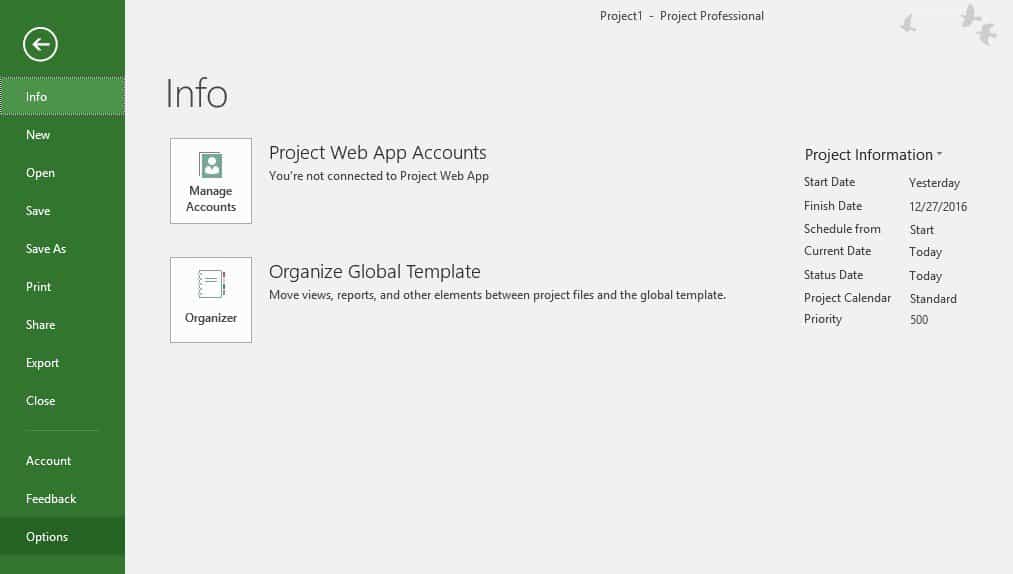

Click File on the menu bar and choose Options (it’s the last choice in the left column). Click Edit project settings.

2. Change Schedule Options

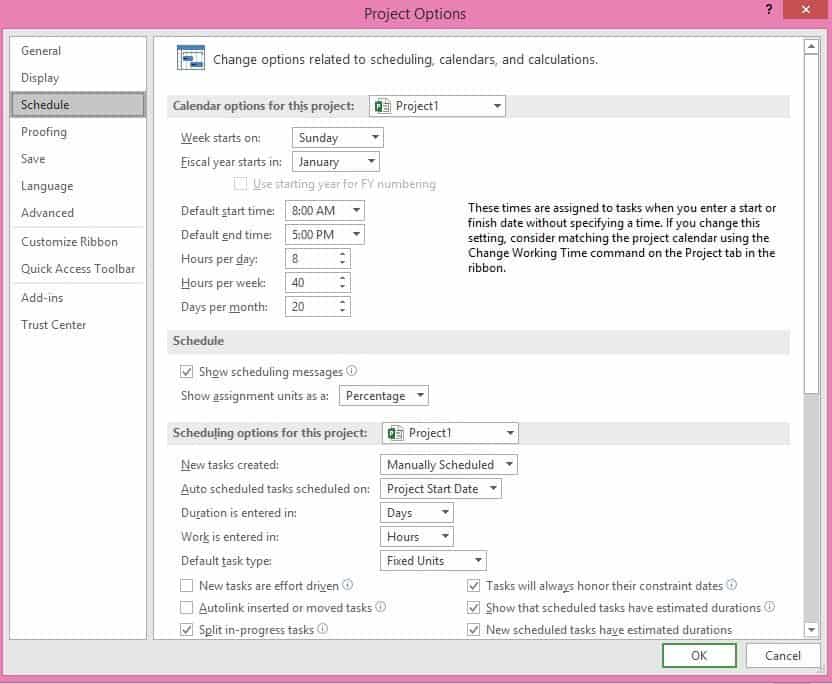

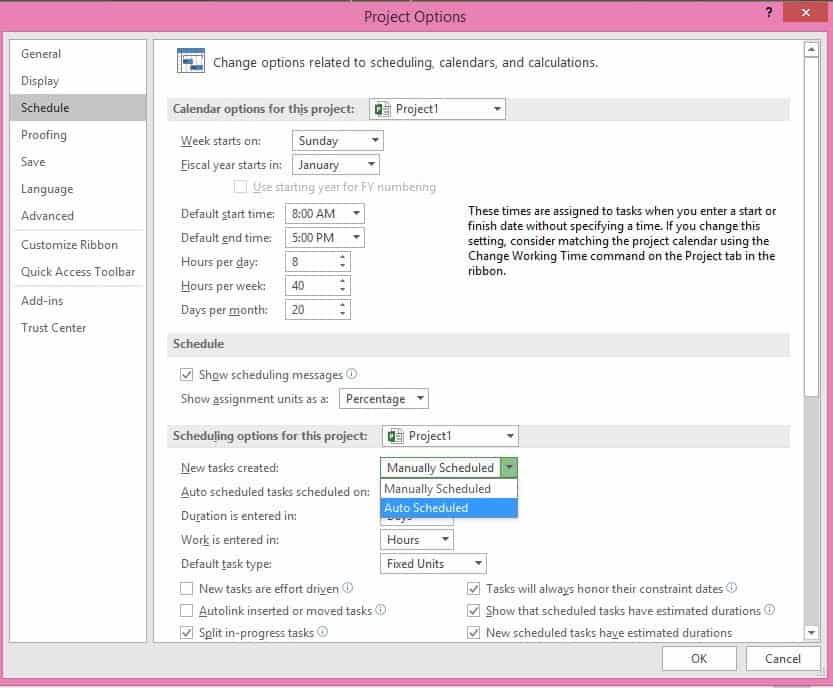

When the Project Options form appears on the screen, click Schedule in the left column.

Next, under Scheduling Options for this Project section, click the drop-down menu for New Tasks Created. The default is set to Manually Scheduled. Select and click Auto Scheduled and click the OK button.

How to Create Task Dependencies in Microsoft Project

Dependencies occur when one task requires another’s completion to move on to the next phase. To create task dependencies in Microsoft Projects, link any two tasks in Gantt chart view. When linked, all changes made to the first task affect the second.

1. Switch to Gantt Chart View
You should still be in the Gantt chart view. If you’re not, click the Gantt chart icon in top left corner of the window.

2. Select Tasks to Link
Click the Task tab in the menu bar. Identify the two tasks in the list that you want to link. Click the first task and press and hold the Ctrl key and select the second task. Click the chain icon in the ribbon to link the tasks. You’ll see an arrow appear on the Gantt chart that connects the items.

Follow the same steps to link additional items.

Generate a Cost Repost in Microsoft Project

Once you have entered your timeline and resource information, you can use Microsoft Project to run a cost overview with the Reports tab. We’ll walk you through the process of generating a cost report below:

1. Select the Report Tab
Click the Report tab to get a quick overview of the reports you can run.

2. Choose a Cost Report to Run

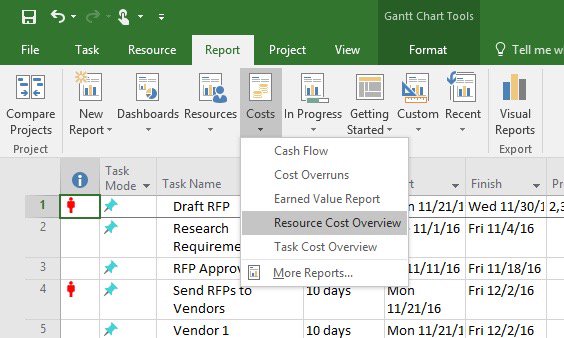

Click the arrow below Costs in the ribbon and click Resource Cost Overview.

A report like the one below will be generated.

Track the Progress of Your Microsoft Project

To track the progress of your Microsoft Project, ensure that you keep the status of tasks updated at all times. Mark tasks on track, and use the completion percentage tools to note which tasks are on time or behind schedule.

1. Mark Tasks That Are on Track

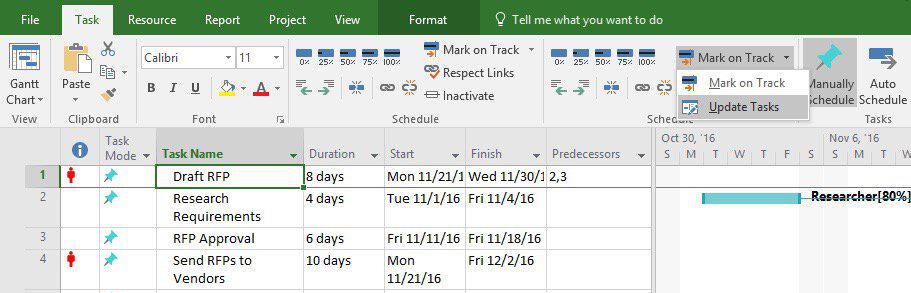

Click the Task tab in the menu bar to see all the task options. Click a task that you want to update. If the task is on track, click the Mark on Track button in the ribbon.

2. Use Predetermined Percentages to Track Tasks
To the left of the Mark on Track option, there are percentages that you can use to denote the progress of a task. Click a task to update and click 0%,25%, 50%, 75%, or 100%. You’ll see a line drawn through the corresponding bar on the Gantt chart that signifies how much of the task is complete.

3. Update Tasks

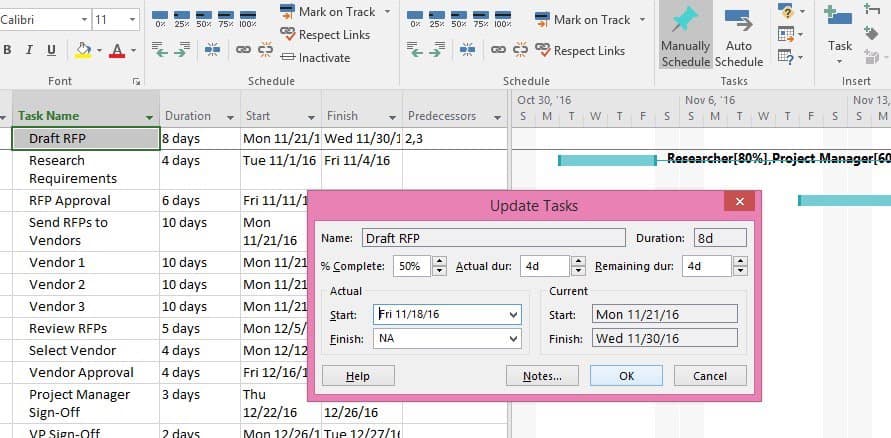

Sometimes tasks fall behind or get accomplished ahead of schedule. You can use the Update Task option to update the status. Click the down arrow next to Mark on Track and click Update Tasks

A dialogue box will appear where you can update status and change start and end dates. Make any changes and click OK.

These are all the steps you need to get started and create a project, assign and manage tasks, and run reports in Microsoft Project 2016.

How to Easily Create a Project Plan and Manage Tasks in Smartsheet

Smartsheet offers a plethora of templates to help you get started using the tool, so there’s no need to start from scratch. You can track and manage projects based on specific industries and uses like basic Agile projects, project management, marketing campaign analysis, customer order tracking, and more. You can even get started with a timeline template and customize it to track your business needs. Best of all, you can share your project with an infinite number of internal and external stakeholders (even if they don’t have a Smartsheet account).

How to Create a Project in Smartsheet
Since we used a timeline to walk you through how to create a project in Microsoft Project, we’re going to do the same process using Smartsheet. We’re also use the example of creating an RFP. Once you create your RFP project in Smartsheet, you can share it with anyone.

Create a Timeline with Smartsheet

Let’s start by creating a timeline, which is easy to do when using a pre-formatted template. There are several templates available that cover the work management needs of many different verticals.

1. Search for a Template

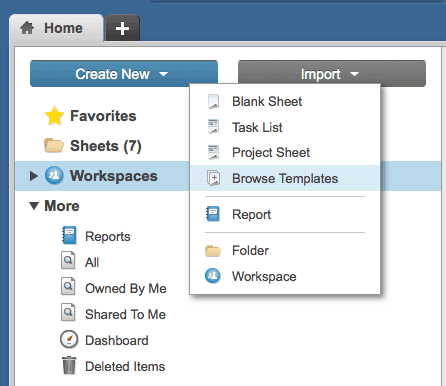

Open Smartsheet, click the Home tab, and click the blue Create New button and select Browse Templates.

Project timeline with Smartsheet

In the Search Templates box, type “Timeline” and click the magnifying glass icon.

How to make a Gantt chart

2. Choose a Template

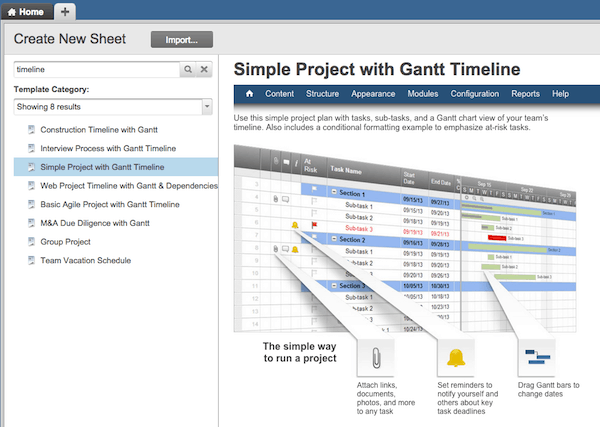

There will be a few options, but for this tutorial, click Simple Project with Gantt Timeline. Next, click the blue Use Template button.

How to make a Gantt chart

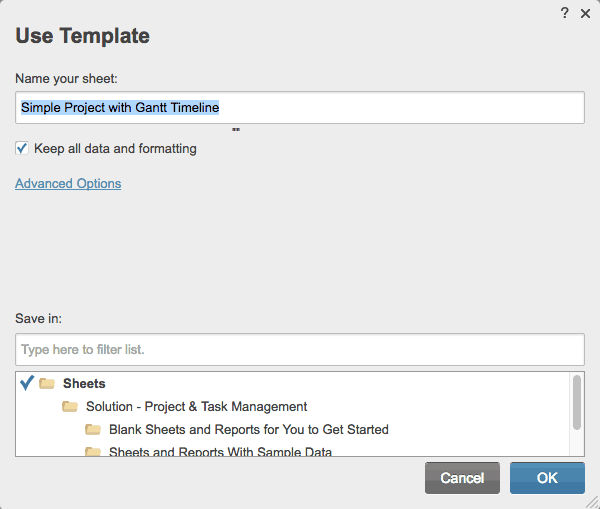

3. Name and save the Template
In the Name Your Sheet box, type the name of the template and select where to save it in Smartsheet. Click OK

4. Add Tasks and Dates

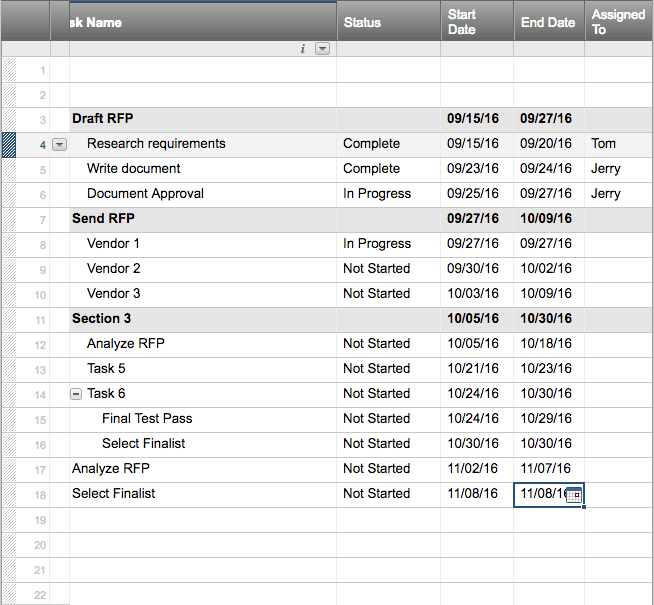

Double click the first gray bar (called Section 1), highlight the existing content, and type your first task. Add start and end dates by clicking the calendar icon and click a start or end date. Continue to fill out all your tasks and start/end dates.

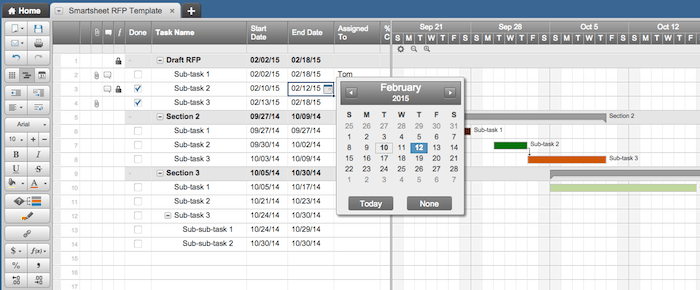

Smartsheet project timeline

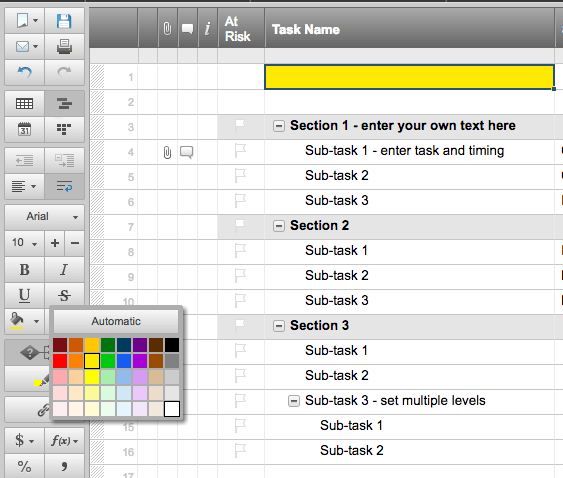

Tip: To remove the yellow Need Help copy at the top of the template, click the box and press Delete on your keyboard. To remove the color, click the color fill option in the toolbar and click Automatic.

5. Add Resources and Assign Tasks
Choose a task to assign a resource and type the name of the resource in the corresponding box in the Assigned To column.

6. Add Task Dependencies

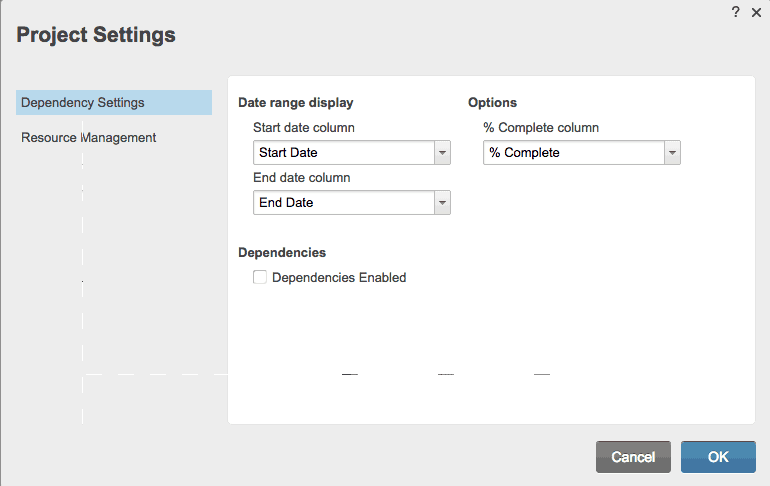

If a specific task can’t be completed until another one is finished, you can add dependencies. Click a column in the sheet, right-click the mouse button and click Edit Project Settings.

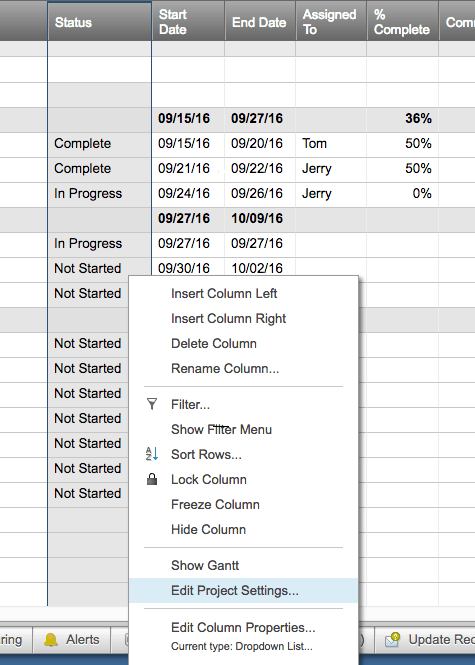

Click the box for Dependencies Enabled, and Predecessor and Duration columns will be added to the sheet. Click the blue OK button. The time is takes to complete each task will automatically be filled in the Duration column.

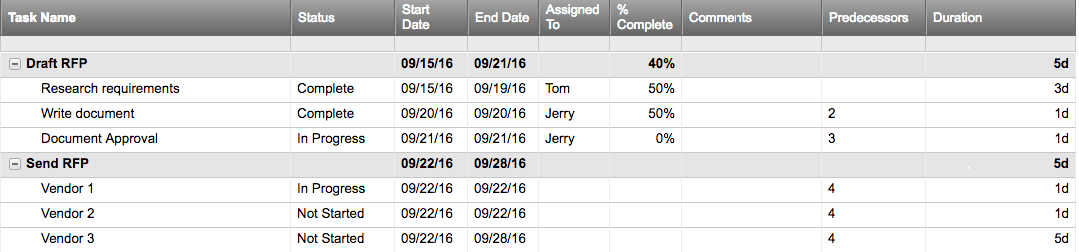

If any task is dependent on another task, type the number of that row in the Predecessor column. For example, in order to write an RFP document, research must be completed first. The task “Research Requirements” is row 2 and “Write Document” is row 3, so type the number 2 in the Predecessors column for row 3.

Click the Grid View icon to see the relationship between tasks appear on In the Gantt chart.

Get More Project Management Flexibility with Smartsheet

From simple task management and project planning to complex resource and portfolio management, Smartsheet helps you improve collaboration and increase work velocity -- empowering you to get more done.

The Smartsheet platform makes it easy to plan, capture, manage, and report on work from anywhere, helping your team be more effective and get more done. Report on key metrics and get real-time visibility into work as it happens with roll-up reports, dashboards, and automated workflows built to keep your team connected and informed.

When teams have clarity into the work getting done, there’s no telling how much more they can accomplish in the same amount of time. Try Smartsheet for free, today.

Discover a better way to streamline workflows and eliminate silos for good.

Try Smartsheet for Free Get a Free Smartsheet Demo
